The real behavioral health EHR implementation timeline vs the vendor's quote

Ask three EHR vendors how long implementation takes and you will get three confident answers, none of which may apply to your organization. This is because the number in their deck was built for a single-program outpatient practice with one clinician type and one payer mix. A behavioral health organization running substance use disorder treatment, outpatient mental health, and maybe a residential or partial hospitalization program under one roof is a different project, and the timeline that actually applies to that project rarely shows up in the sales conversation.

The gap between those two numbers is where budgets go to die. Configuring an EHR, even a fairly complex one, is a bounded, controllable piece of work, and a disciplined, structured build can move fast. A 12-week system configuration and go-live is realistic for the software itself. What actually extends a behavioral health rollout past its promised date almost always sits outside that software track: credentialing, payer enrollment, and the fact that your staff need two different kinds of training instead of one.

Three timeline gaps that delay most behavioral health EHR rollouts

1. Multi-program credentialing runs on its own separate clock

Credentialing is not one process. It runs on at least three separate layers: the individual clinician, the facility, and in many cases the specific program. Being credentialed with a payer for general medical services does not carry over to behavioral health, since most major commercial payers route behavioral health enrollment through a separate managed behavioral health organization with its own application and its own clock. Add a medication-assisted treatment track, an intensive outpatient program, or a residential level of care, and each one can trigger its own enrollment step layered on top of facility-level credentialing.

None of this is paperwork you can skip to hit a go-live date. Providers must be enrolled in Medicare to get paid for covered services, and that enrollment runs through the Provider Enrollment, Chain, and Ownership System, known as PECOS.[1] CMS has continued to build out PECOS specifically to give providers and credentialing staff a way to track applications and manage enrollment status in real time, which tells you something about how much of this process is still administrative rather than clinical.[2] The same logic holds across commercial and Medicaid behavioral health networks. Your system can go live exactly on schedule and still not be able to bill a program until its credentialing catches up.

Standards for how that credentialing gets verified are also getting stricter, not looser. The National Committee for Quality Assurance updated its credentialing standards in 2025, shortening primary source verification windows and requiring a fixed 36-month recredentialing cycle with monthly monitoring in between.[3] That is a tighter, faster-moving target than the loose “every three years or so” assumption a lot of operations teams still plan around.

If a program is new and needs third-party accreditation, that adds a separate track entirely. CARF International accredits behavioral health programs at the individual program level rather than the facility level, which means a newly launched IOP or residential service can need its own accreditation timeline even if the rest of the organization is already accredited.[4] That timeline runs on CARF’s schedule.

2. Payer enrollment multiplies with every program, state, and payer you add

Even once credentialing clears, payer enrollment is its own separate timeline, and it multiplies by every program and every state you operate in. A behavioral health organization with programs in three states and contracts with Medicare, Medicaid, and four commercial payers is not managing one enrollment process. It is managing dozens of them, each with its own portal, its own document requirements, and its own review cycle.

If any of your programs touch substance use disorder treatment, there is another layer on top of that. The confidentiality protections in 42 CFR Part 2 govern how SUD patient records can be used and disclosed, and a final rule from the Substance Abuse and Mental Health Services Administration and the HHS Office for Civil Rights updated those protections to align more closely with HIPAA.[5] That rule took effect April 16, 2024, with a compliance deadline of February 16, 2026. That deadline has now passed. HHS’s Office for Civil Rights launched a civil enforcement program the same week, and began accepting complaints and breach notifications tied to Part 2 violations on February 16, 2026.[6] That work has to happen alongside your EHR build.

3. Training two workforces: clinical staff and revenue cycle staff, on two different curricula

This is the piece that rarely makes it into a vendor’s implementation plan at all. Clinical staff need to learn documentation, treatment planning, and level-of-care workflows in the new system. Revenue cycle staff need a separate curriculum entirely: authorization tracking, program-specific coding, and the billing handoffs between clinical and RCM teams that a generic outpatient practice never has to think about. A timeline built for a single-specialty practice typically budgets training hours for one of these groups. A behavioral health rollout needs to budget for both, run on overlapping schedules, without pulling either team away from patient care or claims for too long.

This lands harder in behavioral health because the workforce doing the training is already stretched. An estimated 137 million people, about 40% of the US population, live in an area with a documented mental health workforce shortage, spread across 6,807 designated shortage areas nationwide.[7] Training time is not a line item you can quietly expand when the people sitting in that training are already covering more caseload than the org chart assumes.

See how a program-by-program rollout actually gets sequenced.

Talk to blueBriX about running credentialing, payer enrollment, and dual clinical and RCM training as one coordinated plan instead of three separate ones.

Schedule a demo

What a realistic timeline actually looks like

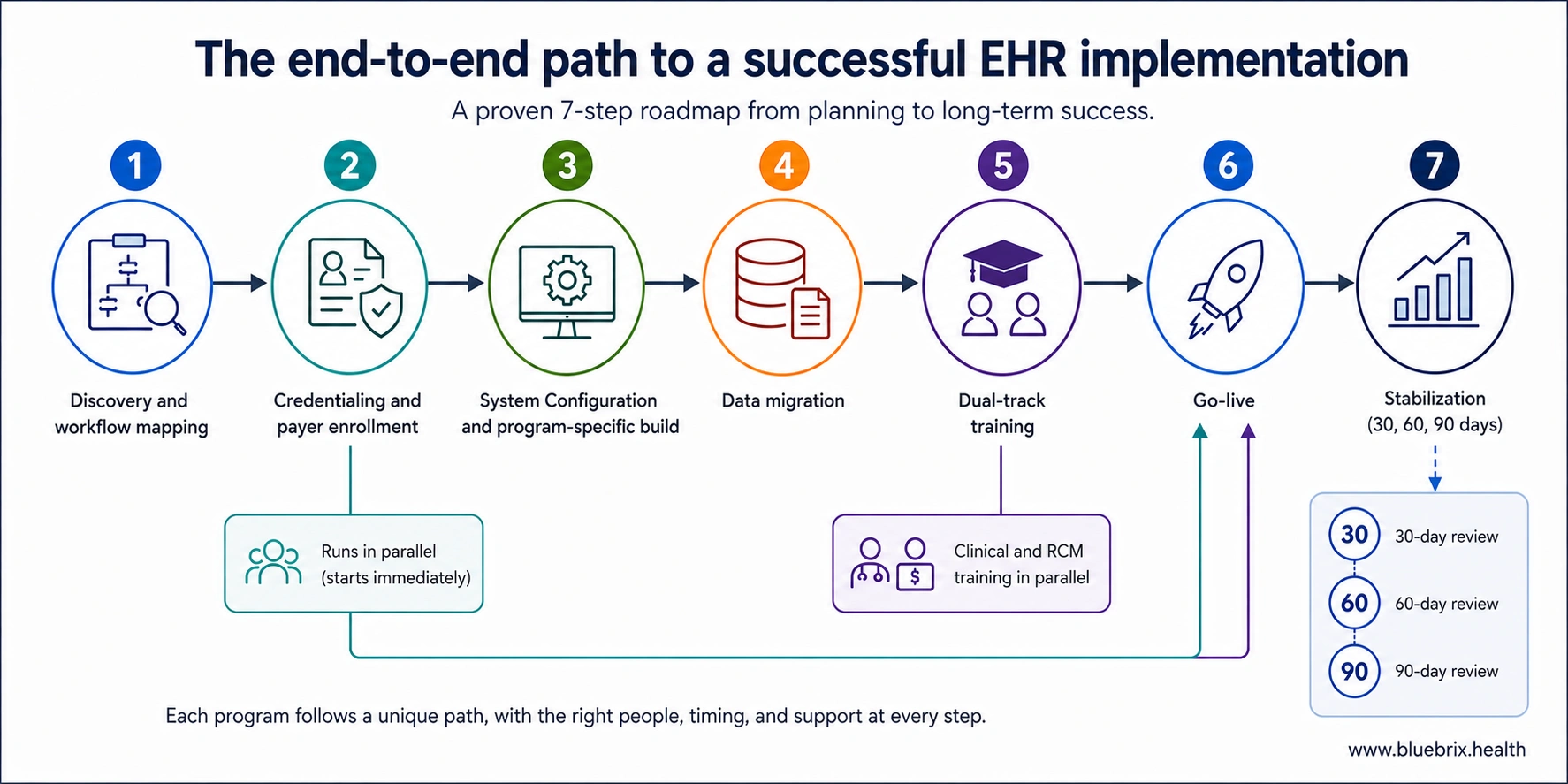

EHR_implementation_roadmap

Rather than a single flat number, think of a multi-program rollout as several tracks running at different speeds, some of which should start on day one regardless of where system configuration stands. On a well-run build, the system configuration and go-live track can complete in about 12 weeks. The tracks below determine how long it takes the rest of the organization to actually catch up to that date.

  • Discovery and workflow mapping. Every program gets its own workflow map, not a shared template, since a residential level of care and an outpatient clinic document and bill differently.
  • Credentialing and payer enrollment. This track should start immediately, in parallel with configuration, not after the system is built. Submitting applications sequentially rather than concurrently is one of the most common and most avoidable causes of a slipped go-live date. Depending on program count and payer mix, this track often runs well past the 12-week system build.
  • System configuration and program-specific build. Templates, code sets, and permissions get configured per program, per level of care.
  • Data migration. Legacy records, treatment histories, and billing data move over and get validated, ideally in test batches before the full cutover.
  • Dual-track training. Clinical and RCM curricula run on parallel schedules, not sequentially, so neither team is left unprepared at go-live.
  • Go-live. Often phased by program rather than all at once, so a program whose payer enrollment is still catching up does not hold back the rest of the organization.
  • Stabilization. A structured 30, 60, and 90-day review after go-live to catch workflow gaps, billing issues, and training gaps before they become entrenched habits.
“The organizations that get burned are almost always the ones that treated credentialing and payer enrollment as something to start after the system was built, instead of a parallel track with its own project manager from day one.”

What a delayed behavioral health EHR go-live actually costs

When a rollout runs past its original date, the costs are not abstract. Running two systems side by side means paying for two licenses, supporting two sets of workflows, and asking staff to double-document, all at the same time. Any disruption to claim submission, eligibility verification, or payer connectivity has an immediate effect on cash flow, and the longer that disruption runs, the more it complicates denial follow-up and reconciliation later on.[8] That is why organizations like MGMA recommend building a documented transition and downtime plan before go-live, rather than improvising one after a delay has already started.[9]

Behavioral health adds its own specific version of this problem. If system go-live outpaces payer enrollment for even one program, that program cannot bill through the new system for services it is already delivering. Claims stack up, accounts receivable ages, and the finance team ends up doing the exact manual reconciliation work the new system was supposed to eliminate.

There is a staffing cost too. Extending a dual-training period, or running clinical and RCM teams through it back to back instead of in parallel, adds weeks of reduced capacity in a workforce that was already short-staffed before the project started.

5 questions to ask before you sign a behavioral health EHR contract

A vendor’s proposed timeline will tell you a lot about whether they understand behavioral health specifically, or whether they are quoting from a generic template. Before you sign, ask:

  1. How is credentialing and payer enrollment sequenced against system go-live? Can they run in parallel, or does one wait for the other?
  2. How many training hours are budgeted for clinical roles versus revenue cycle roles, and are they treated as two separate curricula?
  3. Can you show a reference implementation with a similar program mix, not just a similar organization size?
  4. What is the plan if one specific program’s payer enrollment lags behind the rest of the go-live date?
  5. What does the stabilization period after go-live actually look like, and who owns it on the vendor’s side?

A vendor who can answer all five specifically, with real numbers instead of ranges, is quoting you a timeline built for your organization. A vendor who cannot is quoting you the same number they give everyone else.

Choosing a vendor who can coordinate credentialing, training, and go-live

Most of the timeline risk covered in this piece traces back to one root cause. You end up treating credentialing, payer enrollment, clinical documentation, and revenue cycle training as separate workstreams, run by separate people, sometimes on separate systems, each keeping its own clock. That fragmentation is what turns a six-month quote into a nine-month reality.

blueBriX runs these as one coordinated implementation plan instead of three or four disconnected ones. On a well-scoped rollout, system configuration and go-live take about 12 weeks. Credentialing and payer enrollment start on day one alongside that build, running on their own timeline rather than waiting for the system to be finished. Clinical and revenue cycle training run on parallel schedules instead of waiting on each other. Go-live gets phased by program, so one lagging payer enrollment does not hold back your entire organization. That coordination is exactly where most of the gap between a quoted date and a real one gets closed, even when credentialing for a specific program takes longer than the system build itself.

If you are evaluating vendors for a multi-program rollout, ask every vendor how they coordinate these tracks, not just the one you are already leaning toward. The answer will tell you more about your real go-live date than anything in their sales deck. Once you know how a vendor handles that coordination, you know roughly how much of the quoted timeline you can actually trust. For more details, talk to blueBriX about what a realistic, program-by-program timeline looks like for your organization specifically.

Schedule a conversation now.

About the author

G.Kapil Nandakumar

Kapil Nandakumar is a Product Owner and Marketing Leader at blueBriX, where he drives product strategy and go-to-market execution for a platform purpose-built for US behavioral health and integrated care. With over 13 years of experience across product ownership and digital marketing, he specializes in translating the operational complexity of payer requirements, value-based care models, and behavioral health workflows into structured, adaptable product capabilities. At blueBriX, he has contributed to workflow-driven capabilities that support revenue integrity, documentation accuracy, and care coordination for behavioral health organizations. He is a Certified Scrum Product Owner (CSPO), applying that product discipline to how behavioral health organizations adopt and scale technology. https://in.linkedin.com/in/kapilnandakumar

Contributor

Suresh Kumar

Suresh Kumar M is Vice President of Revenue Cycle Strategy at blueBriX, where he leads revenue cycle strategy for organizations navigating complex billing and reimbursement operations. He holds an MBA and earned his AAPC Certified Professional Biller (CPB) certification, building on more than 18 years in healthcare revenue cycle management across physician practices, specialty clinics, behavioral health organizations, and hospitals. Under the RCM strategy he leads at blueBriX, client engagements have delivered measurable results: reducing accounts receivable days from over 120 to 35 within three weeks for one specialty practice and driving a 6% revenue increase alongside a 15% reduction in coding-related denials within 60 days for a 140-bed hospital. His work spans billing operations, denial management, accounts receivable, and credentialing, applying EHR, EDI, and AI-driven automation to modernize how that work gets done.

References

  1. Centers for Medicare & Medicaid Services. Medicare Provider Enrollment (MLN9658742) https://www.cms.gov/Outreach-and-Education/Medicare-Learning-Network-MLN/MLNProducts/EnrollmentResources/provider-resources/provider-enrolment/Med-Prov-Enroll-MLN9658742.html
  2. Centers for Medicare & Medicaid Services. PECOS Fact Sheet, December 2024. https://www.cms.gov/files/document/pecos-fact-sheet.pdf
  3. National Committee for Quality Assurance. NCQA’s Credentialing Standards Help Ensure Safety and Integrity of Practitioner Networks. https://www.ncqa.org/blog/ncqas-credentialing-standards-ensure-safety-and-integrity-of-practitioner-networks/
  4. CARF International. Behavioral Health Accreditation. https://carf.org/accreditation/programs/behavioral-health/
  5. U.S. Department of Health and Human Services. Fact Sheet: 42 CFR Part 2 Final Rule. https://www.hhs.gov/hipaa/for-professionals/regulatory-initiatives/fact-sheet-42-cfr-part-2-final-rule/
  6. Federal Register. Confidentiality of Substance Use Disorder (SUD) Patient Records, 89 FR 12472 https://www.federalregister.gov/documents/2024/02/16/2024-02544/confidentiality-of-substance-use-disorder-sud-patient-records
  7. Health Resources and Services Administration, Bureau of Health Workforce. Designated HPSA Quarterly Summary, First Quarter of Fiscal Year 2026 (data as of December 31, 2025). https://data.hrsa.gov/default/generatehpsaquarterlyreport
  8. Healthcare Financial Management Association. Why Revenue Cycle Teams Must Prepare for Extended Downtime in the Age of Cyber Threats. https://www.hfma.org/technology/cybersecurity/why-revenue-cycle-teams-must-prepare-for-extended-downtime-in-the-age-of-cyber-threats/
  9. Medical Group Management Association. Averting Crisis with a Well-Documented Plan for EHR, RCM Downtime https://www.mgma.com/mgma-stat/averting-crisis-with-a-well-documented-plan-for-ehr-rcm-dowtime

Frequently asked questions

It depends far more on how many programs and payer networks you operate across than on the software itself. A single-program outpatient practice moves through implementation faster than a multi-program organization running SUD, mental health, and residential care under separate credentialing and payer tracks.

Yes, and they should. Waiting until the system is built to start credentialing and payer enrollment is one of the most common ways a timeline slips, since those processes run on their own independent clocks that will not speed up to match a go-live date.

For organizations with substance use disorder programs, yes. The final rule aligning Part 2 with HIPAA carried a compliance deadline of February 16, 2026, which has now passed, and OCR is actively enforcing it. Consent, disclosure, and system configuration work tied to the rule needs to be built into the implementation plan from day one, not treated as a separate project to catch up on later.

Running two systems in parallel, which means double licensing, double documentation, and staff time split across both platforms for longer than the budget assumed. It rarely shows up in the original business case because the original timeline assumed the delay would not happen.

Under NCQA standards, the fixed cycle is 36 months from the date of last approval, with monthly monitoring of exclusions and license status in between.[

It can, especially for a newly launched program. CARF accredits at the program level, so a new residential or IOP service can need its own accreditation timeline running alongside, not instead of, your EHR rollout.

blueBriX starts credentialing and payer enrollment on day one, running in parallel with system configuration instead of waiting for the build to finish. Go-live is phased by program, so a program whose payer enrollment is still in process does not hold back the rest of your organization.

blueBriX runs a structured 30, 60, and 90-day review after go-live to catch workflow gaps, billing issues, and training gaps before they become entrenched habits, rather than treating go-live as the finish line.
